The industrial-scale threat

The Musina-Makhado SEZ

and the Greater Soutpansberg Coalfield

The false promise of heavy industrialisation

The architects of the Musina-Makhado SEZ promise deliverance from joblessness for the impoverished Vhembe and proclaim themselves visionaries who will give rise to the coming century’s Witwatersrand, built not on gold, but on steel and coal. It is a lie. The economic fault lines upon which Makhado’s great arc and blast furnaces will be built run deep. A terrible price will be paid for any jobs it spawns and those jobs will not last. It is an environmental and economic Chernobyl.

What is the MM-SEZ?

Coal-fueled industrialisation of Limpopo’s Far North

The Musina-Mahado Special Economic Zone is a large-scale industrial development that is the undergirding of an ambitious plan to industrialise the remote Vhembe region of South Africa’s northern Limpopo Province based on the exploitation of its coal resources.

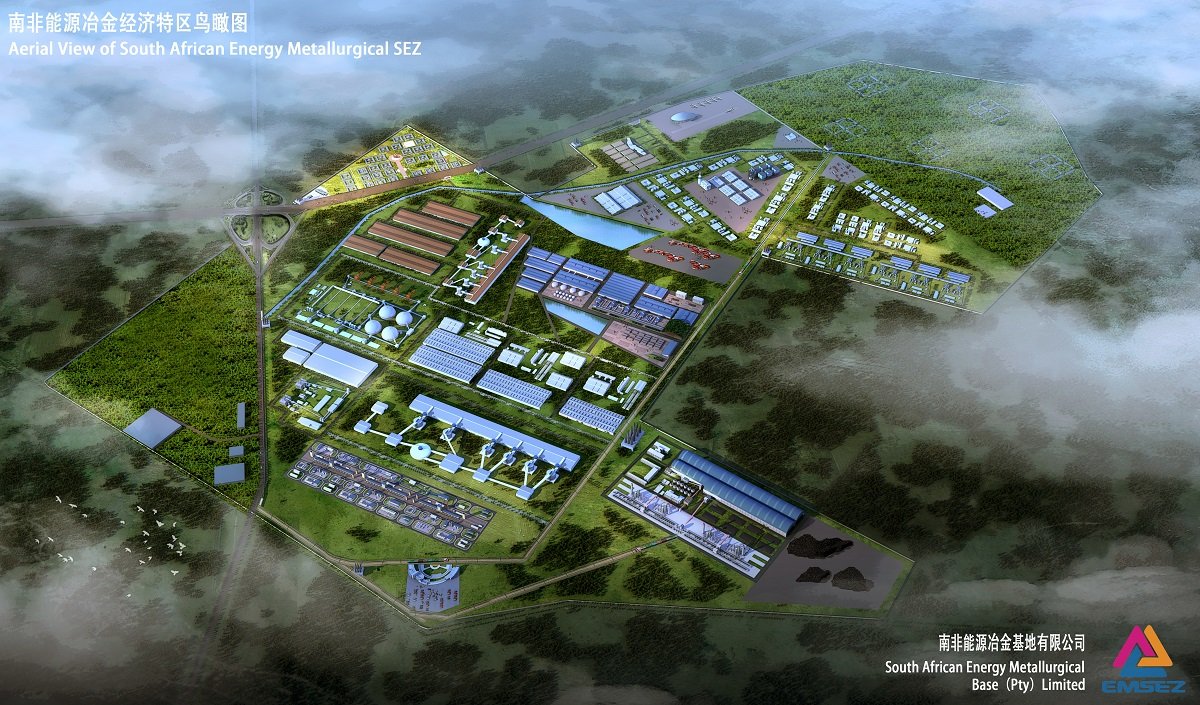

The scale of the project is immense. The MMSEZ spans an area of 60 Km2 encompassing multiple industrial sites and extensive infrastructure development, ranging from power and petrochemicals plants, to a mega-dam on the Limpopo River and the so-called “Smart City” township.

The flagship project is the energy-metallurgical zone of the MM-SEZ that will manufacture crude steel in a production sequence from coking coal produced from raw coal mined locally, to pig iron, to steel and ferro-alloys.

The SEZ will cost the national fiscus over US$22 billion to develop and will be the biggest such industrial development in South Africa. The metallurgical zone will more than double SA’s steel manufacturing capacity and is seen as the key to unlocking the coal reserves of the Greater Soutpansberg Coalfields.

Coal

The Raw Material

The Greater Soutpansberg Coalfield

The MM-SEZ is openly intended to drive the exploitation of the coal reserves of the Greater Soutpansberg Coalfield.

The Tuli, Mopane, Tshipise and Pafuri coalfields that together comprise the Greater Soutpansberg Coalfield, extend across a 200 Km ‘strike distance’ between the Soutpansberg Mountains in the south and the Limpopo River in the north, and contain an estimated 10 billion tons of thermal and coking coal.

Coal is a primary input of steel and a latter-day ISCOR is being built in Limpopo’s northern coalbelt to support and enable the mining of this ‘land-locked’ resource:

  • The SEZ will create a purpose-built buyer for the coal in the coalfield, and

  • will fund the development of dedicated infrastructure including the rail links to port that will enable the export of raw coal along with the zone’s output.

The proximity to coal as a raw material is cited in all planning and marketing documents as the primary rationale for the project and its remote location. The smelter and petrochemical plants will be supplied by the 12 new open-cast coal mines planned for which the Department of Mineral Resources and Energy (DMRE) has granted licenses.

Credit: Toni Oliver; Source

MM-SEZ Quick Fact File

  • Project name

    The Musina-Makhado Special Economic Zone or MM-SEZ and in particular, the MM-SEZ South Site designated as the “South African Energy Metallurgical Zone of the Musina-Makhado Special Economic Zone” (SAEM-SEZ or EMSEZ).

  • Location

    Vhembe District in the northernmost province of Limpopo, South Africa. The metallurgical South Site is situated north of the town of Makhado. The North Site is situated close to the border town of Musina on the Limpopo River.

  • Type of project

    Large-scale mega-project.

    Heavy industry: Metallurgical with a focus on steel manufacturing. Estimated annual output of 30.1Mt of ferrous metals.

    Linked to plans for power and water supply as key dependencies: A 1,320-3,300MW power plant and a mega dam to be built on the Limpopo River.

  • Project developers

    China-Africa Capacity Co-operation project.

    Shenzhen Hoimor Resources Holding Co. Ltd. (Hong Kong) [Operator]: South African Energy Metallurgical Base Pty Ltd (South Africa) [subsidiary]

    Musina-Makhado SEZ (SOC) Ltd (South Africa)

  • Project cost and funding

    Development cost in the order of US$22bn (R344bn), including internal and external bulk services and private investment in the plants totaling US$16.9bn (R247.8bn).

    Investor pipeline announced but funding plans are opaque.

  • Project status

    Planning stage: During 2017 SEZ designated (south site only); state-owned company registered; operator license issued.

    Environmental Authorisation granted 23 February 2022; all appeals dismissed 7 July 2022; High Court application brought December 2022 - trial date pending

Background

What is a Special Economic Zone?

A Special Economic Zone is the Department of Trade and Industry or dtic jargon for an industrial zone offering special sweetners, such as subsidised factory rents and infrastructure paid for from the public purse, tax breaks and other ‘concessions’ to attract much-fetishised FDI in manufacturing. They are meant to be little utopias for big business - places where power and water are cheap and the taxman is barred at the same factory gates where workers lose their right to strike.

It’s a model China evangelises, part of a mining and industry-skewed developmental state orthodoxy to which the SA government is a convert. Since the adoption of the SEZ Policy in 2012 and passing of the SEZ Act in 2014, 11 such zones have sprouted across the country with scant regard for the critical conditions that predict success or failure.

Results so far disappoint.

Where is the MM-SEZ?

The MM-SEZ is located in the northernmost Vhembe District of South Africa’s northernmost province of Limpopo, in the municipal districts of Musina and Makhado.

Spanning some 60Km2 between the Soutpansberg mountains in the south and the Limpopo River in the north, the zone encompasses multiple development sites.

The Energy-Metallurgical Zone or South Site of the MM-SEZ, which is located north of the Soutpansberg Mountains on 8,000 Ha of land belonging to the Mulambwane community, is the only site to have actually been designated an SEZ.

The Plans

For Mining and Industrial Development in the Vhembe District

Metallurgy

Petrochemicals Manufacturing and Logistics

Power Supply

Water Supply

Backing and Funding

Who is behind the MM-SEZ?

Embed from Getty Images

State-backing

The MM-SEZ has been sanctioned as a China-Africa Production Capacity Co-operation deal and is part of the Belt & Road Initiative.

It is sponsored by South Africa’s Department of Trade and Industry (DTIC), the Limpopo provincial government’s Department of Economic Development Environment and Tourism (LEDET) and its Limpopo Economic Development Agency (LEDA), as well as China’s National Development and Reform Commission.

For coal

There is little justification for why South Africa is ‘co-operating’ with China in this instance to massively ramp up its national steel production capacity at a remote site in northern Limpopo despite 1) its own steel industry overcapacity and 2) the costly logistical disadvantages of the location, beyond the fact that steel is coal-intensive and will make mining the Greater Soutpansberg Coalfield profitable at last:

The smelter will create a purpose-built buyer for coal on the edge of the coalpits and the SEZ will fund the dedicated infrastructure, including the rail network upgrades, needed to enable the export of raw coal to China and other buyers. The MMSEZ in other words, will make Limpopo’s worthless coal ‘endowment’ worth mining.

Extent of MC Mining’s tenements held in the Greater Soutpansberg Coalfield which extends in an east-west belt across the Limpopo River Valley north of the Soutpansberg Mountains. Source: MC Mining

Costs: From R1 to R100bn

The cost to develop the zone quoted in the September 2019 Masterplan is a whopping R344bn (US$22.25bn), broken down as follows:

  1. External bulk infrastructure: R56bn (US$3.73bn)

  2. Internal bulk services: R40bn (US$2.66bn)

  3. Plant: R247bn (US$16bn)

Funding

Funding plans have never been disclosed. The Operator Agreement and Masterplan do however split “responsibility” for funding as follows:

  1. External bulk infrastructure (US$3.73bn) - SA fiscus

  2. Internal bulk services (US$2.66bn) - Operator/MM-SEZ SOC

  3. Plant (US$16bn) - Private Investors

Why are we opposed to the Musina-Makhado SEZ?

How the Musina-Makhado SEZ and the exploitation of the Greater Soutpansberg Coalfield threatens the Vhembe.

- De-Industrialise Limpopo's future - Leave the coal buried in the ground

- De-Industrialise Limpopo's future - Leave the coal buried in the ground
